20.01.2012

Concreting To Pile #A94-800mm dia. -Absorbers Foundation -SinoHydro.

Boring To Pile #A27-800mm dia. -Absorbers Foundation -SinoHydro.

Fabric Filter -Curing In Progress -Grid 4 -Grid 6.

F2 -Foundation -Type A/B/C -Formwork Installation In Progress.

F1-Foundation -Boiler -West Side-Hacking Of Piles (4nos) In Progress.

F4 -Foundation -Type E -Preparation For Steel Fixing -Bottom Layer In Progress.

F2-Foundation -Type-F -Steel Reinforcement -Bottom Layer.

F3 -Foundation -Boiler -East Side -Concreting In Progress.

F11 -Foundation -Boiler -Excavation In Progress.

BOP -MCWS -Reclamation Area -Piling -Spun Pile -600mm dia. In Progress.

BOP -MCWS -Reclamation Area -Piling -Spun Pile 600mm dia. In Progress.

CEB -Preparation For Lean Concrete & Pile Hacking.

BOP -Intake Box Culvert -Fabrication In Progress -Murray Robert.

BOP -Intake Box Culvert -Fabrication In Progress.

BOP -Intake Box Culvert -Fabrication In Progress -Murray Robert.

Consortium Office -Alstom -Front View.

Consortium Office -Alstom.

Consortium Office -Alstom -Grd.Floor.

Consortium Office -Alstom -1st Floor.

Consortium Office -CMC/TNBJ/OE.

F2-Foundation -Type A/B/C -Final Inspection Prior Concreting -Boiler -East Side.

F2 -Foundation -Type A/B/C -Final Inspection Prior Concreting.

F2 -Foundation -Type A/B/C -Final Inspection Prior Concreting -Boiler -East Side.

19.01.2012

Installation -Steel Cage -Pile #HN56-1200mm dia. -Chimney -BOP -EconPile.

Boring To Pile #A23-800mm dia. -Absorbers Foundation -SinoHydro.

F4-Foundation -Type-E -Boiler -Hacking Of Piles In Progress.

F3 -Boiler -East Side -Ready For Final Inspection.

F2-Foundation Type F -Boiler -East Side -Preparation -Steel Fixing -Bottom Layer.

Removing Of Sheet Piles -Bunker/Mill -North Side -B17/B15.

Mill -D -Brickwall Formwork In Progress.

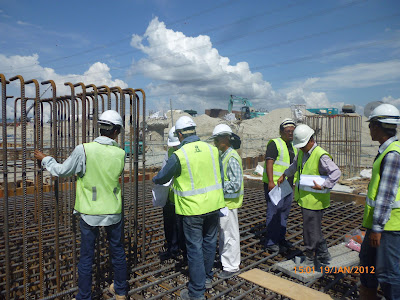

Final Inspection -F3 -Boiler -East Side -Prior Concreting.

Final Inspection -F3 -Boiler -East Side -Prior Concreting.

Concreting To Pile #HN56-1200mm dia. -Chimney -BOP. -EconPile.

18.01.2012

Excavation -Preparation For F4 -Foundation -Type A & D-Boiler.

Sheet Piling -Coffer Dam -F1 -Foundation -Type A/B/C -Boiler -West Side.

F1 -Boiler -West Side -Backfilling & Compaction -9th Layer.

Mill -D -Brickwall Formwork In Progress.

Bunker/Mill -B1-B3 -BA/BB -Curing In Progress.

Turbine Hall -Excavation -2nd Stage (South/East Side) .

Turbine Hall -Excavated Area -2nd -Stage -(-2.1MLSD).

PDA -CWP -Turbine Hall -Pile # QA19 -BOP.

F3 -Boiler -East Side -Inspection -Steel Reinforcement -Top Layer.

F3 -Boiler -East Side -Inspection -Steel Reinforcement -Top Layer.

Boring To Pile #HN07 -1200mm dia. -Chimney -BOP -EconPile.

Concreting To Pile #A92-800mm dia. -Absorbers Foundation -SinoHydro.

17.01.2012

Bunker/Mill -B1-B3 -BA/BB -Curing In Progress.

Mill -E -Compaction-4th Layer In Progress.

Mill -E -Steel Fixing -2nd Stage.

FDT -Mill -D -FDT -4th Layer In Progress.

Installation -Steel Cage -Pile #HN52-1200mm dia. -Chimney -BOP.

PIT -Ash Hopper.

Concreting To Pile #HN52-1200mm dia. -Chimney -BOP -EconPile.

Concreting To Pile #A32-800mm dia-Absorbers Foundation -SinoHydro.

Sheet Piling -Coffer Dam -F4 -Type -E -Foundation -Boiler.

F2 -Type A &B -Boiler East Side -Steel Fixing -Pile Caps & Tie Beams.
