07.01.2012

Fabric Filter -Final Preparation Prior Concreting -Scheduled On 10.01.2012 @ 120m3.

F2 -Boiler -East Side -Preparation For Backfilling Works.

Sheet Piling -Coffer Dam -F2-Type 2F -Foundation -Boiler -East Side.

F3 -Boiler -East Side -Hacking Of Piles & Carting Away Of Debris (Hacked Piles).

Bunker/Mill -B11 -B7 -BA/BB -Curing In Progress.

Bunker/Mill -B11-B7 -BA/BB -Curing In Progress.

Bunker/Mill -B5 -B1 -BB -Installation Of Formwork In Progress.

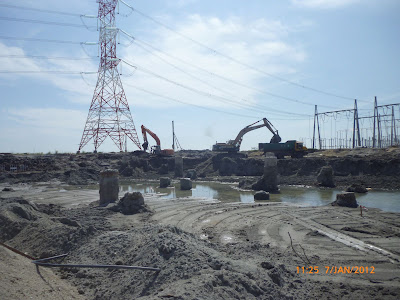

Turbine Hall -Excavation-1st Stage In Progress.

Turbine Hall -Excavation -1st Stage In Progress.

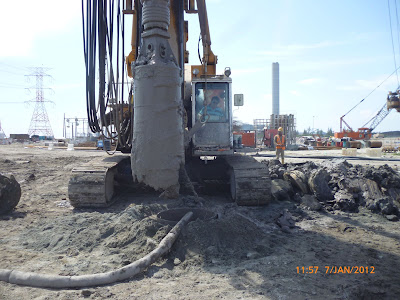

Boring To Pile #A74-1000mm dia. -Absorbers Foundation -EconPile.

Concreting To Pile #A50-800mm dia. -Absorbers Foundation -EconPile.

Consortium Office -Alstom.

F1 -Boiler -West Side -Final Preparation Prior Concreting.

F1 -Boiler -West Side -Final Preparation Prior Concreting.

06.01.2012

Boring To Pile #A44 -1000mm dia -Absorbers Foundation -EconPile.

Fabric -Filter -Preparation Prior Concreting.

F1 -Boiler -West Side -Formwork Completed.

F3 -Boiler -West Side -Formwork Installation -Stump.

F3 -Boiler -West Side -Formwork For Stump.

F3 -Boiler -East Side -Carting Away Of Debris (Hacked Piles).

Steel Cutting & Bending -Bunker/Mill.

Bunker/Mill -B1-BA -Steel Fixing -Type 2 Foundation.

CCB -Excavation In Progress.

Turbine Hall -Excavation-1st Stage In Progress.

Turbine Hall -Excavation -1st Stage In Progress.

Bunker/Mill -B1-BA -Steel Fixing -Foundation Type 2.

FDT -Bunker/Mill -B15 -4th Layer.

Bore Rigs -SinoHydro -Mobilized To Absorbers Area -Preparation To Commence.

BOP -Sub-Station -Project Power Supply -Re-Bar Preparation -Base Slab & Beams.

Installation Of Casing -Pile #A13 -1000mm dia -Absorbers Foundation -SinoHydro.

Concreting To Pile #A41 -800mm dia. -Absorbers Foundation -EconPile.

F1 -Boiler -West Side -Preparation To Install Re-Bar For Stumps.

F3/F6 -Boiler -West Side -Removing Of Sheet Piles (Coffer Dam).

F3/F6 -Boiler -West Side -Backfilling -7th Layer In Progress.

05.01.2012

Boring To Pile #A46 -800mm dia. -Absorber Foundation -EconPile.

Fabric Filter -Scheduled For Concreting -Grid 1 -Grid 3 @ 100m3 On 07.01.12.

F1 -Boiler -East Side -Steel Reinforcement Completed.

F2 -Boiler -East Side -Preparation For Backfilling Works.

F7 -Boiler -East Side -Carting Away Of Hacked Piles.

F3-Boiler -East Side -Hacking Of Piles.

Bunker/Mill -Backfilling & Compaction -5th Layer -B17.

Backfilling & Compaction 5th Layer -Bunker/Mill -B17.

Final Inspection Prior Concreting -Bunker/Mill -B11 -B7 -BA/BB.

Concreting -Bunker/Mill -B11 -B7 -BA/BB @ 330m3.

Concreting To Pile #A66 -1000mm dia. -Absorber Foundation -EconPile.

Fabric Filter -Inspection Of Re-Bar Prior Shuttering Works -Grid 1 -Grid 3.

Fabric Filter -Grid -1 -Grid-3 -Inspection Of Re-Bar Prior Shuttering Works.

F1 -Boiler -West Side -Installation Of Formwork.

F1 -Boiler -West Side -Inspection Of Re-Bar Prior Shuttering Works.



F1 -Boiler -West Side -Steel Reinforcement Completed.
