03.02.2012

Fabric Filter -Final Preparation Prior Concreting -Gridline 6 -Gridline 8.

F11 -Foundation -Boiler -Hacking Of Piles In Progress.

Boring To Pile #HN49-1200mm dia. -Chimney -BOP -EconPile.

F2-Foundation -Type A/B/C -Boiler -East Side -Formwork Installation In Progress.

F2-Foundation -Type-F -Boiler -East Side -Curing In Progress.

F2-Foundation -Type F -Boiler -East Side -Curing In Progress.

Mill -C -Brickwall Formwork In Progress.

Dismantling Of Sheet Piles (Coffer Dam) -F3/F7 -Boiler -East Side.

F3/F7 -Boiler -East Side -Compaction -In Progress (7th Layer).

F2-Foundation -Type-F -Boiler -East Side -Curing In Progress.

Boring To Pile#HN43-1200mm dia. -Chimney -BOP -SinoHydro.

Concreting To Pile #HN49-1200mm dia. -Chimney -BOP -EconPile.

01.02.2012

Boring To Pile #HN48-1200mm dia. -Chimney -BOP -EconPile.

Boring To Pile #B03-800mm dia. -Booster Fan -SinoHydro.

F2 -Foundation -Type A/B/C -Boiler -East Side -Steel Fixing -Tie Beams In Progress.

Mill -H -J-Bolts Frame -Setting Up In Progress.
F11-Foundation -Boiler -Hacking Of Piles (12 nos).

Steel Cage Installation -Pile #HN48-1200mm dia. -Chimney -BOP -EconPile.

Concreting -Pile #B03 -800mm dia. -Booster Fan -SinoHydro.

F2-Type A/B/C -Boiler -East Side -Steel Fixing -Tie Beam In Progress.

F3-Boiler -East Side -Compaction (Backfilling Works) In Progress.(4th Layer).

F2-Type-F -Boiler -East Side -Final Inspection Prior Concreting.

31.01.2012

BOP -Intake Box Culvert -Coffer Dam In Progress.

BOP -Intake Box Culvert -Preparation Works In Progress.

BOP -Intake Box Culvert -Excavation To Shore Protection.

Boring To Pile #HN27 -1200mm dia. -Chimney -BOP -EconPile.

Boring To Pile#B02-800mm dia. -Booster Fan -SinoHydro.

Fabric Filter -Steel Fixing & Formwork Installation -Gridline 6 -Gridline 8.

F2-Type -F -Final Preparation In Progress -Prior Concreting.

F7/F3 -Boiler -East Side -Backfilling-1st Layer In Progress.

F7/F3 -Foundation -Boiler -East Side -Backfilling -1st Layer In Progress.

F11 -Foundation -Boiler -Preparation For Lean Concreting.

J-Bolts -Frames -Mill -H -Preparation In Progress.

Mill -H -Preparation To Intsall-I-Beam Support For -J-Bolts -Frame.

F2-Type-F -Boiler -East Side -Pre-Pour Inspection.

F2 -Type-F -Boiler -East Side -Pre-Pour Inspection.

30.01.2012

Installation Of Steel Cage -Pile #B16-800mm dia. -Booster Fan -SinoHydro.

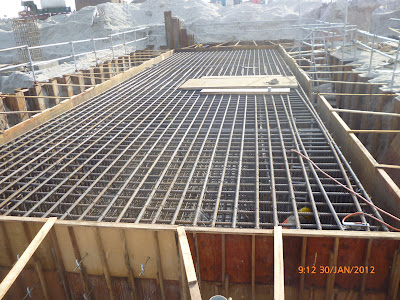

Fabric Filter -Steel Fixing & Formwork Installation -Grid 6 -Grid 8.

F2 -Type -F -Boiler -East Side -Formwork Installation Completed.

F4 -Type E -Foundation -Boiler -Preparation For Formwork Installation.

F11 Foundation -Boiler -Preparation For Lean Concreting.

F7 -Boiler -East Side- Steel Fixing -Stump.

Steel Fixing -Mill -G -Final Stage Pour.

Brickwall Formwork -Mill -D.

CEB -Lean Concrete Completed -Gridline -2.

CEB -Preparation For Lean Concrete.

Turbine Hall -Excavation -2nd Stage (-2.1MLSD) -South/West Side.

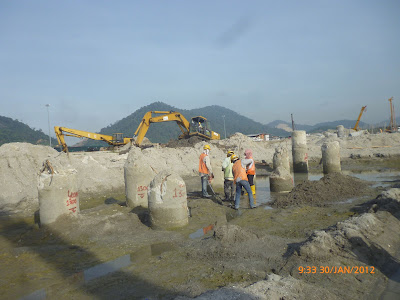

F1-Foundation -Boiler -West Side- Cleaning (Hacked Piles) .

PIT -F1 -Foundation -Boiler -West Side.

F2 Foundation-Type F -Boiler -East Side -Steel Fixing -Stump In Progress.
