Consortium Office -Alstom -Laying Of Bricks In Progress.
Hacking Of Piles -Bunker/Mill -B11.
Bunker/Mill -B9 -Preparation For PIT & Steel Reinforcement Installation.
Applying Of Curing Compound -Bunker/Mill -1st Pour Foundation -B7.
Applying Of Formwork Oil -Preparation For Bunker/Mill -1st Pour -B9.
Lean Concrete -Bunker/Mill -B13.

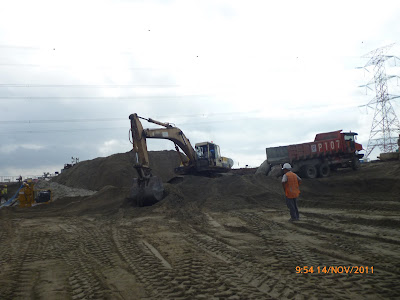

Excavation To Boiler Area -East Side.
Installation Of Dewatering Pipes -Boiler -East Perimeter -87/120 Points Completed.
Consortium Office -Laying Of Bricks In Progress.
Consortium Office -Alstom -Laying Of Bricks In Progress.
Consortium Office -Alstom -Laying Of Bricks/Installation Of Door Frames/Preparation Of Mock-Up Unit In Progress.

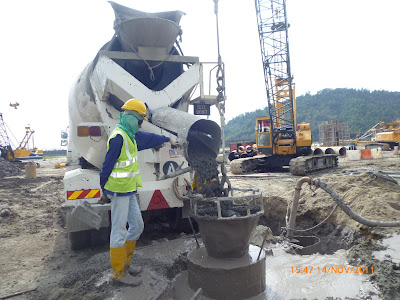

Concreting To Pile #B15-800mm dia. -FGD -Econpile.

MLT -Pile #B57 -1200mm dia. -Boiler In Progress -1141Ton.
MLT -Pile #B57 -1200mm dia. -Boiler -In Progress =1141Ton.
Site Office -Murray Robert -Off-Shore Works/Water Intake.
Sheet Piles -Preparation Works -Water Intake/Off-Shore Works -Murray Robert.
