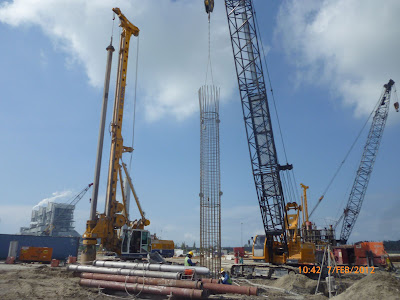

07.02.2012

Steel Cage Installation -Pile #HN36-1200mm dia. -Chimney -BOP -SinoHydro.

Boring To Pile #HN08-1200mm dia. -Chimney -BOP -EconPile.

F1 -Foundation -Boiler -West Side -Steel Fixing -Stump.

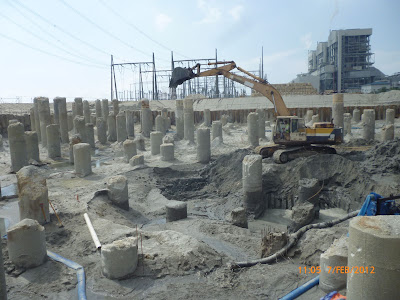

Crushing Of Hacked Piles -Boiler.

F4-Foundation-Type A -Boiler -East Side -Preparation For Steel Fixing.

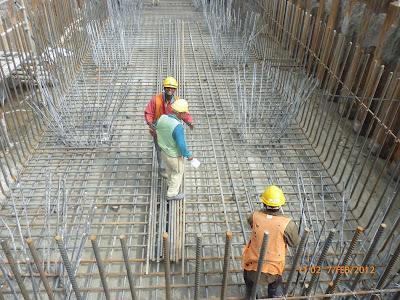

F10-B14 -Foundation -Boiler -East Side -Steel Fixing -Bottom Layer In Progress.

F11-B4 -Foundation -Boiler -West Side -Excavation In Progress.

F6 -Boiler -West Side -Cleaning Prior Formwork Installation.

F6 -Foundation -Boiler -West Side -Hacking Works (Construction Joint -Stump).

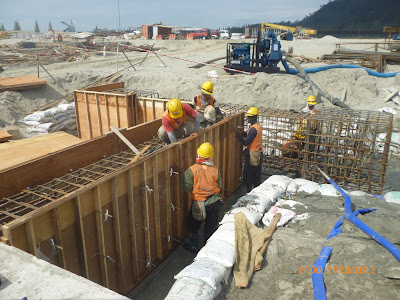

F6 Foundation -Type -A -Boiler -West Side -Formwork Installation.

F10 -B14 -Boiler -East Side -Steel Fixing -Bottom Layer In Progress.

Mill-H -Installation Of Formwork.

Mill-H -Installation Of Formwork.

Turbine Hall -Excavation-3rd Stage Down To Level (-3.6MLSD).

Turbine Hall -Excavation 3rd Stage In Progress (-3.6MLSD).

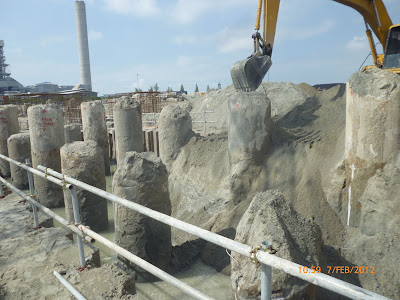

CEB -Hacking Of Piles In Progress -Gridline -2 -A/G.

CEB -Preparation For Lean Concrete -Grid 1 -A-G.

F4-Type-E -Boiler -East Side -Curing In Progress.
